Ammonia oxidation reactor plant, the catalytic step of nitric acid production

Decoding the Critical Path in Chemical Plant Execution: From Paperwork to First Batch

Project Execution · Chemical Engineering

Ask ten people on a chemical project site what the critical path is and you will get ten answers. Most of them will say the reactor, the imported column, or the line item with the biggest number on it. None of that is the critical path. The critical path does not care what anything costs — it is an arithmetical property of the dependency network, and on a well-built schedule it usually runs through something nobody is watching: a drawing approval loop, a boiler inspectorate submission, a QC method validation.

What this article gives you

The precise definition, the six-step calculation you can do on paper, a ten-activity worked example, and a fully computed 72-activity network for a ₹180–220 Cr multiproduct batch plant — 103 weeks from design basis freeze to first on-spec batch, with two parallel critical paths. Every number in the worked examples is calculated from the logic shown, not asserted. The three interactive tools on this page run the same forward-pass / backward-pass solver live in your browser, so you can break the network yourself and watch what happens.

1. The fallacy of the big equipment

You cannot erect a reactor until three things are ready: the foundation (10 weeks), the reactor itself (30 weeks), and a crane (1 week to mobilise). All three start today and run at the same time.

The earliest you can erect is 30 weeks from now. The reactor sets that date. The foundation has 20 weeks of spare time and the crane has 29 — either can slip by that much and the erection date will not move. The reactor has none. Delay it by a week and you erect a week later.

That is the textbook definition, and three things about it are routinely ignored.

  • Longest, not most important. The path is set by summed duration through logic links. A ₹18 Cr autoclave with a 32-week fabrication cycle is probably on it. A ₹4 lakh sample cooler is probably not — unless it is the last item needed to close a system for hydro test, in which case it is, and its price is irrelevant.
  • It is a property of the network, not of the bar chart. If the schedule was built by typing in dates, there is no critical path in it at all. Dates are outputs of the calculation, not inputs to it.
  • It always exists, and there can be more than one. Even a project eight months late has a critical path. If no path shows zero float, the network has open ends or hard constraints hiding the answer. Two or more paths of equal length are common and must be managed simultaneously — the worked example below has exactly this.

Working vocabulary

TermMeaning
DurationWorking time to complete the activity, on the applicable calendar
Predecessor / successorLogic link between activities; usually finish-to-start (FS)
LagImposed waiting time on a link (e.g. concrete curing). Not a substitute for an activity
Early Start (ES)Earliest the activity can start given all its predecessors
Early Finish (EF)ES + duration
Late Finish (LF)Latest it can finish without delaying the project
Late Start (LS)LF − duration
Total float (TF)LS − ES. Delay the activity can absorb before the project end date moves
Free floatDelay it can absorb before the next activity’s early start moves
Critical pathThe chain of activities where total float = 0
Near-criticalFloat small relative to project duration — in practice, under about 10%
Write this into the contract

Total float belongs to the project, not to whichever contractor is sitting on it. Put that in the conditions, or in month fourteen you will find a vendor consumed twelve weeks of float on a non-critical item and three paths are now critical at once.

2. The six-step calculation, by hand

The method is a forward pass, a backward pass, and a subtraction. It takes ten minutes on paper for a twenty-activity network. Doing it by hand once teaches more than three years of clicking Schedule in Primavera.

#StepWhat it means in practice
1Define the finishMechanical completion, RFSU, first product, or first on-spec product at design rate? On a multiproduct plant the gap between mechanical completion and first on-spec batch is routinely four to six months. Pick first on-spec batch — it is the only definition a promoter recognises.
2DecomposeOne activity, one owner, one verifiable deliverable. Duration one to four weeks on a two-year job. Longer than two reporting cycles means it will sit at “60% complete” for five months.
3Assign logic, not datesPredecessors and successors only. Every hard constraint (“start no earlier than”) is a point where the network stops calculating and starts obeying — and obedient schedules warn you about nothing.
4Forward passES = the latest EF among all predecessors; EF = ES + duration. Work left to right. The largest EF in the network is the project duration.

In plain words — Walk the project from day one towards the end, asking the same question at every activity: what is the earliest this could possibly begin? Nothing can start until every one of its predecessors is finished, so you look at all of them and take the latest one. Add the duration and you have the earliest it can finish. Keep walking forward and the last number you write down is the earliest date the project can finish — not the date anyone promised, the date the logic permits. It is the arithmetic of planning a journey outward: leave at six, reach the first stop at eight, the next at eleven.
5Backward passLF = the earliest LS among all successors; LS = LF − duration. Work right to left from the project end date.

In plain words — Start with a flight you have to board at 9:00 am. You do not plan this forwards from the time you wake up; you fix the 9:00 and work backwards through every step. Boarding is 9:00, and check-in and security take an hour, so you must be at the airport by 8:00. The drive takes two hours, so you must leave home by 6:00. That 6:00 is not the time you would like to leave. It is the last possible moment you can leave and still make the flight — leave at 6:15 and the flight goes without you.

That is the backward pass, and the technical version is the same arithmetic. You start at the project finish date and work right to left. An activity must be complete before the latest start of every one of its successors, so its late finish is the earliest of those late starts, and its late start is LS = LF − duration. Note the mirror: going forwards you took the latest of the predecessors, going backwards you take the earliest of the successors. When you finish, every activity in the network carries its own private deadline — the last date it can move before the plant moves with it.

So why bother, when the forward pass already gave you dates? Because the forward pass answers only “when can this happen”, and on its own it makes all seventy-two activities look equally urgent. It cannot tell you which ones you are allowed to be late on. The backward pass supplies the second number — “when must this happen” — and only with both in hand can you subtract one from the other. That subtraction is the float in step 6: the gap between the earliest an activity could start and the latest it is allowed to start. Skip the backward pass and you have no deadlines, no float and no critical path, just a list of early dates with no way of telling which of them actually decide your first on-spec batch.
6Float, and the answerTF = LS − ES. Every activity with TF = 0 is on the critical path. String them together in ES order.

In plain words — Float is simply the gap between the two answers you have just calculated: how late an activity is allowed to start, minus how early it could have started. It is spare time — how long that activity can be delayed before the finish date itself moves. Twenty weeks of float means twenty weeks can be lost with no effect on the end date. Zero float means there is no spare time at all, so any delay at all is a delay to the plant. That is the entire definition of the critical path: the activities that have no spare time. And float belongs to the schedule, not to the team sitting on it — whoever spends it first has spent it for everyone downstream.

The two omissions that break most networks

These are not scheduling errors. They are the environment in which activities actually get done, left out of the model.

  • Approval loops. “TBE” is not one week. It is technical evaluation, commercial comparison, negotiation, internal note and sign-off — six weeks in most Indian corporates, ten if a board sub-committee is involved. Put the real number in.
  • Non-construction activities. Statutory consent, licensor deliverables, catalyst procurement, analytical method development, operator recruitment and training, product-specific gaskets and seal elastomers. None of these appear in a contractor’s schedule, because none of them are the contractor’s scope. They are still on your critical path.

3. Worked example A — ten activities, on paper

One block of a multiproduct plant — the high-pressure hydrogenation module — reduced to ten activities. Durations in weeks from design basis freeze. Work through the tables with a pencil; the arithmetic is the whole skill.

Input: activity list and logic

IDActivityDuration (wks)Predecessor
AP&IDs issued for design — hydrogenation block13—
BAutoclave mechanical datasheet3A
CRFQ float and quote receipt4B
DTBE, CBE, PO release6C
EVendor GA drawing + IBR Form III-C approval8D
FFabrication (Hastelloy C-276)32E
GFoundation design (needs vendor load data)4E
HPiling and foundation execution14G
IFinal inspection, dispatch, transit, ODC permits6F
JErection and alignment3H, I
Work the forward pass yourself, then open this to check
IDLogicDurESEFNote
Astart13013
Bafter A31316
Cafter B41620
Dafter C62026
Eafter D82634
Fafter E323466
Gafter E43438branches from E
Hafter G143852
Iafter F66672
Jafter H and I37275ES = max(52, 72)

Project duration for this block: 75 weeks.

Backward pass and float
IDESEFLSLFTotal floatCritical
A0130130YES
B131613160YES
C162016200YES
D202620260YES
E263426340YES
F346634660YES
G3438545820
H3852587220
I667266720YES
J727572750YES

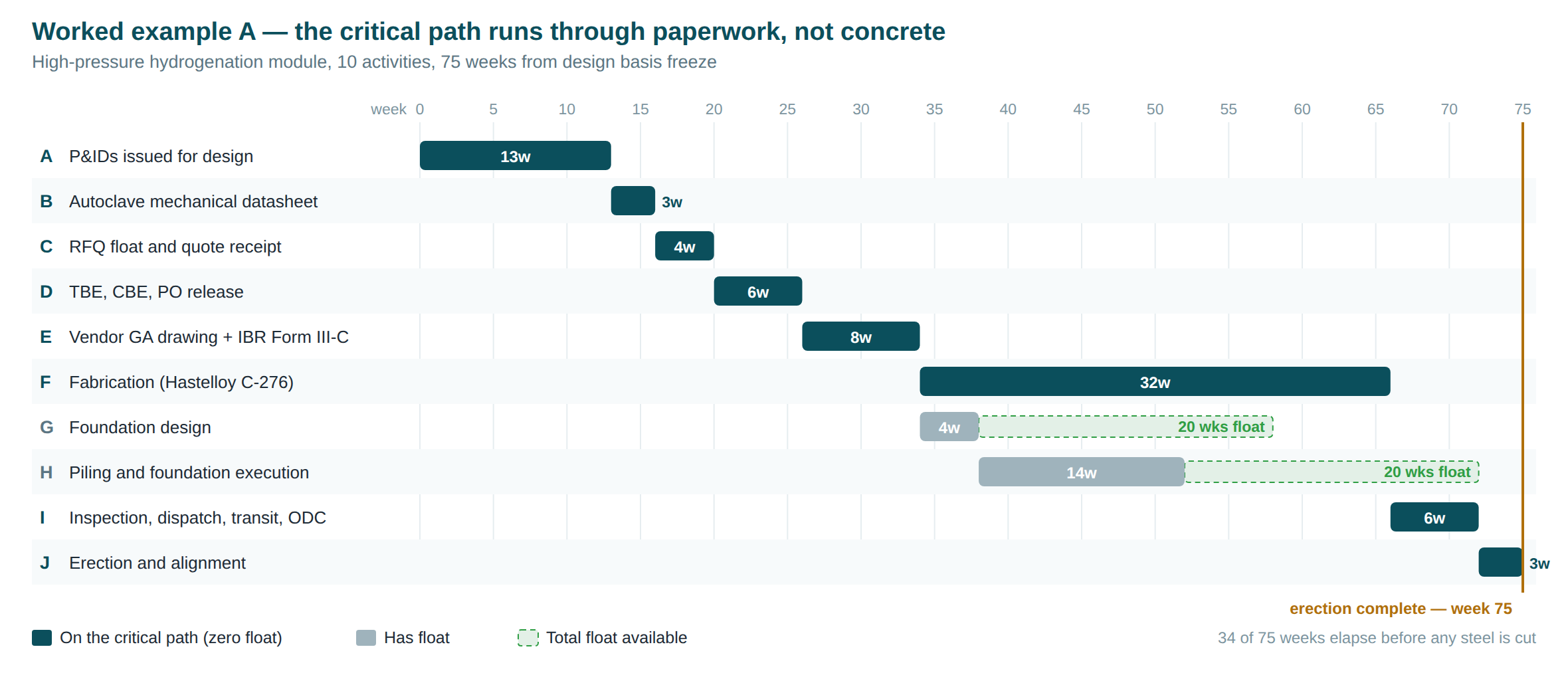

Gantt chart of the ten-activity hydrogenation module network. The critical path runs A to B to C to D to E to F to I to J through drawings, datasheet, RFQ, TBE, vendor GA drawing, IBR Form III-C approval and fabrication, while piling and foundation execution carry twenty weeks of total float.
The same ten activities, drawn to scale. The dark bars are the critical path. Everything before week 34 is paperwork — a drawing, a datasheet, an enquiry, a comparison statement, an internal approval and a boiler inspectorate stamp. The civil work, which is the only thing visible from the gate, has twenty weeks of float.

Reading the result

The critical path is A → B → C → D → E → F → I → J. Now look at what that means on site.

The civil work carries twenty weeks of float. Piling, foundations — the thing visible from the gate, the thing that generates photographs for the monthly review. It is not critical, and will not become critical unless someone lets it slip five months.

The critical path is a paper trail. Thirty-four of the seventy-five weeks are consumed before a single piece of steel is cut: drawings, a datasheet, an enquiry, a comparison statement, an internal approval, and a boiler inspectorate stamp.

And note activity E

The vendor GA drawing feeds both fabrication and foundation design. It is the highest-leverage single activity in the network — a one-week slip there costs a week of end date and burns a week of civil float at the same time. Those are the activities to protect. They are rarely the ones getting attention.

Where the network splits into two paths

Up to this point the network is single file. A → B → C → D → E is one activity after another: 13 + 3 + 4 + 6 + 8 = 34 weeks, with nothing to choose between and nothing to compare. At E that ends.

Activity E — the vendor GA drawing and its IBR Form III-C approval — releases two successors at the same instant. F (fabrication) can start because the vendor finally has an approved drawing to cut metal against. G (foundation design) can start because that same drawing carries the load data the civil designer has been waiting for. From week 34 the project is running two chains that never touch each other again until erection.

Branch leaving E at week 34ChainWeeks of workArrives at J
EquipmentF fabrication (32) → I inspection, dispatch, transit, ODC permits (6)38week 72
CivilG foundation design (4) → H piling and foundation execution (14)18week 52

Activity J, erection and alignment, needs both — a vessel on site and a foundation to stand it on. So J does not start when the first chain arrives in week 52. It starts when the last one arrives in week 72, and the block finishes at 72 + 3 = week 75.

Two different rules, and mixing them up is where schedules go wrong

Along a chain you add. 32 + 6 = 38 weeks of fabrication and logistics.

At a merge you take the larger and discard the smaller. max(72, 52) = 72.

The discarded 52 is not wasted information. The gap between the two arrivals is the float: 72 − 52 = 20 weeks — which is exactly the total float the backward pass hands to G and H.

What you get if you refuse to split

Both shortcuts are wrong, in opposite directions

Add all ten durations: 13 + 3 + 4 + 6 + 8 + 32 + 4 + 14 + 6 + 3 = 93 weeks. Eighteen weeks too pessimistic. It pretends the civil team stands idle until the vessel lands, which is precisely what the logic says they do not do.

Quote the longest activity: fabrication, 32 weeks. Forty-three weeks too optimistic. It ignores the 34 weeks of paperwork that must finish before fabrication can begin, and the 9 weeks of handling and erection after it.

Only max(72, 52) produces 75. Splitting the network is not a refinement of the calculation — it is the calculation.

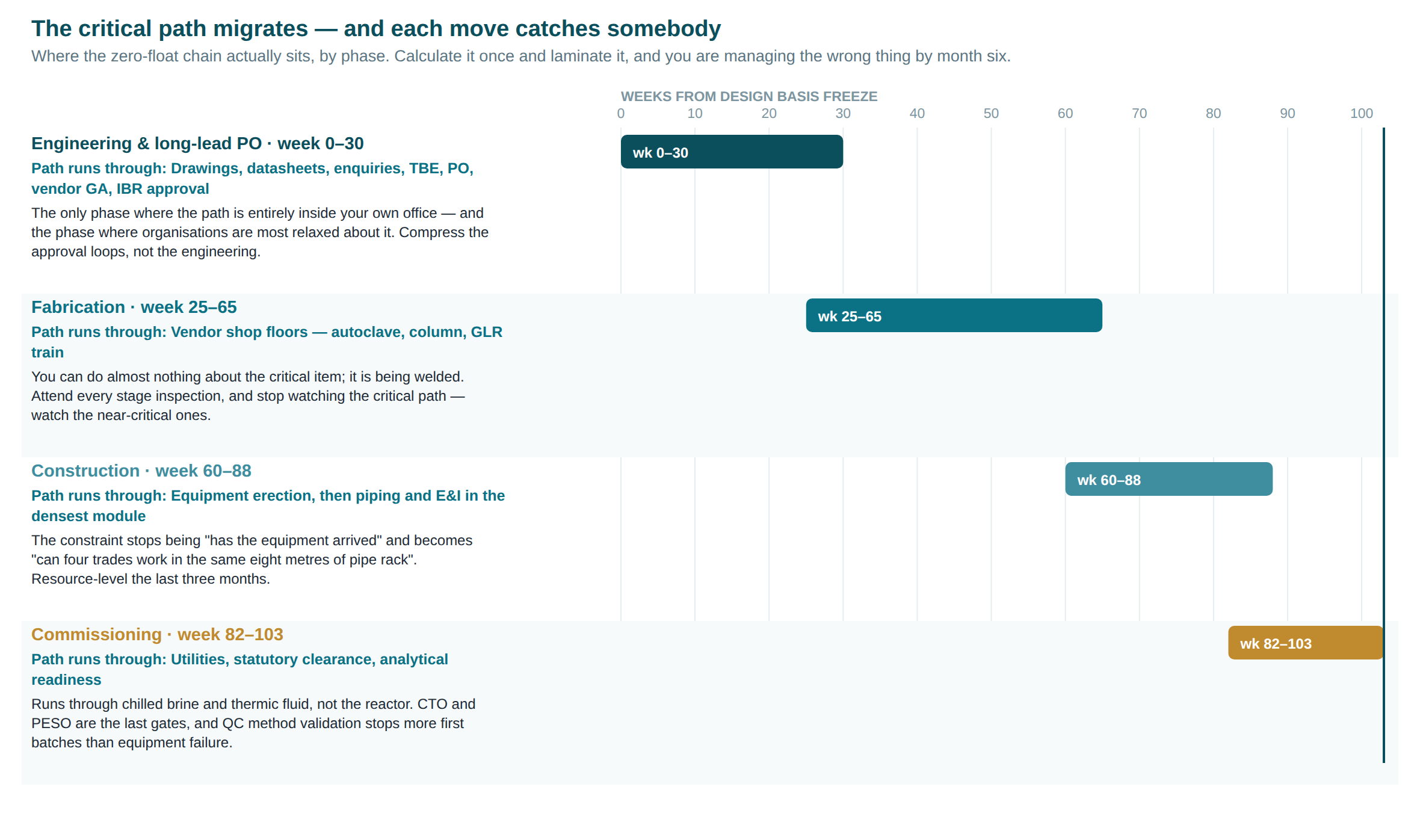

Why the split is the thing you actually track

Once the two chains are separated they are not equally important, and they do not become equally important again until the float is gone. Hold fabrication steady and let only the civil chain slip:

Civil slips byCivil reaches JJ startsFirst batchCivil float leftWhat has actually happened
052727520 wkOn plan
5 wk57727515 wkNo delay. Float absorbed it, silently
10 wk62727510 wkStill no delay. Half the buffer is gone
20 wk7272750Still no delay — but now two critical paths
25 wk777780−5 wkFive weeks late. The critical path has moved to the civil chain

Read the last two rows again. Twenty-five weeks of slip produced five weeks of delay, because twenty weeks of it were paid for out of a float balance nobody was watching. And somewhere between those two rows the critical path stopped running through fabrication and started running through piling — the migration section 7 deals with.

Now do the same thing to the equipment chain and the arithmetic is brutally different. Every week of fabrication slip moves first batch by exactly one week, starting with the very first week. There is no buffer to spend. One week late on F is one week late on the plant.

The asymmetry, in one line

Twenty weeks lost on piling costs nothing. One week lost on fabrication costs a week. A progress report that does not separate the two chains cannot tell you which of those two things happened this month.

The number that lies

Stand at week 52 and look at this project honestly.

  • Seven of the ten activities are complete — A, B, C, D, E, G and H. The dashboard reads 70 per cent.
  • The civil chain is finished. It will consume no more float and it can no longer hurt you.
  • The equipment chain has completed 18 of its 38 weeks: 47 per cent. It is the only thing standing between you and first batch.
  • Twenty-three weeks remain, and not one of them belongs to civil.

The seventy per cent is arithmetically correct and managerially worthless. It reads high precisely because the cheap, easy, visible chain finished early — and it will keep reading high right up to the week the vessel fails to arrive.

What the tracker should carry instead

One line per path, never one line for the project. Equipment chain: required week 72, forecast week ___. Civil chain: required week 72, forecast week ___, float 20 weeks.

Report float as a falling balance, not as a status. Twenty weeks, then fifteen, then ten is a trend you can see coming months in advance. “Civil — on track” gives you nothing, and both statements can be true on the same day.

Set the alarm well before zero. At twenty weeks of civil slip the project acquires a second critical path and twice as many ways to be late. That moment — not the first day of visible delay — is when people and money should move.

Ten activities give you one fork and two paths, and you can hold both in your head. The plant in the next section has seventy-two activities. The arithmetic does not change at all; only the bookkeeping does.

4. Worked example B — the 72-activity multiproduct plant

Now the full network. Basis: a multiproduct batch facility of the order of ₹180–220 Cr — glass-lined and stainless trains for chlorination and nitration service, a separate high-pressure hydrogenation block, solvent recovery, scrubbing and effluent, DCS with ESD, three product campaigns planned in year one. Design basis frozen at Day 0. Finish defined as first on-spec batch of Product 1.

ParameterValue
Start pointDesign basis freeze, Week 0
Finish pointFirst on-spec batch of Product 1
Activities72, across five workstreams
Time unitWeeks; single 6-day working calendar assumed
Relationship typeFinish-to-start throughout; no leads, no lags, no hard constraints
Computed duration103 weeks — approximately 24 months
Critical paths foundTwo, running in parallel and converging at hydro test (C120)
Longest fabricationHastelloy C-276 autoclave, 32 weeks

The activity register — what every code on this page means

Every activity in the network carries a code. The letter is the workstream — Engineering, Procurement, Construction, Statutory, and X for commissioning — and the number is its position in that workstream. Codes such as E070 or S070 appear throughout the rest of this article, and every one of them is a link: click any code and the register below opens at that activity, with its duration, its predecessors and its computed float. Hovering a code shows the activity name without leaving the paragraph.

Open the full activity register — all 72 activities, with duration, logic and computed float

ES, EF and total float are computed by the same forward-pass / backward-pass solver that drives every calculator on this page, on the baseline durations. Enter your own durations in the Gantt builder below and those numbers move; this register always shows the published baseline.

One deliberate choice is embedded in the logic

Long-lead process datasheets (E070) are released off the issued-for-review P&IDs rather than waiting for HAZOP close-out. This is standard fast-tracking and it saves three weeks — but it is also the reason HAZOP carries eleven weeks of float in the result. Fast-tracking does not remove risk from the schedule. It converts duration risk into change risk.

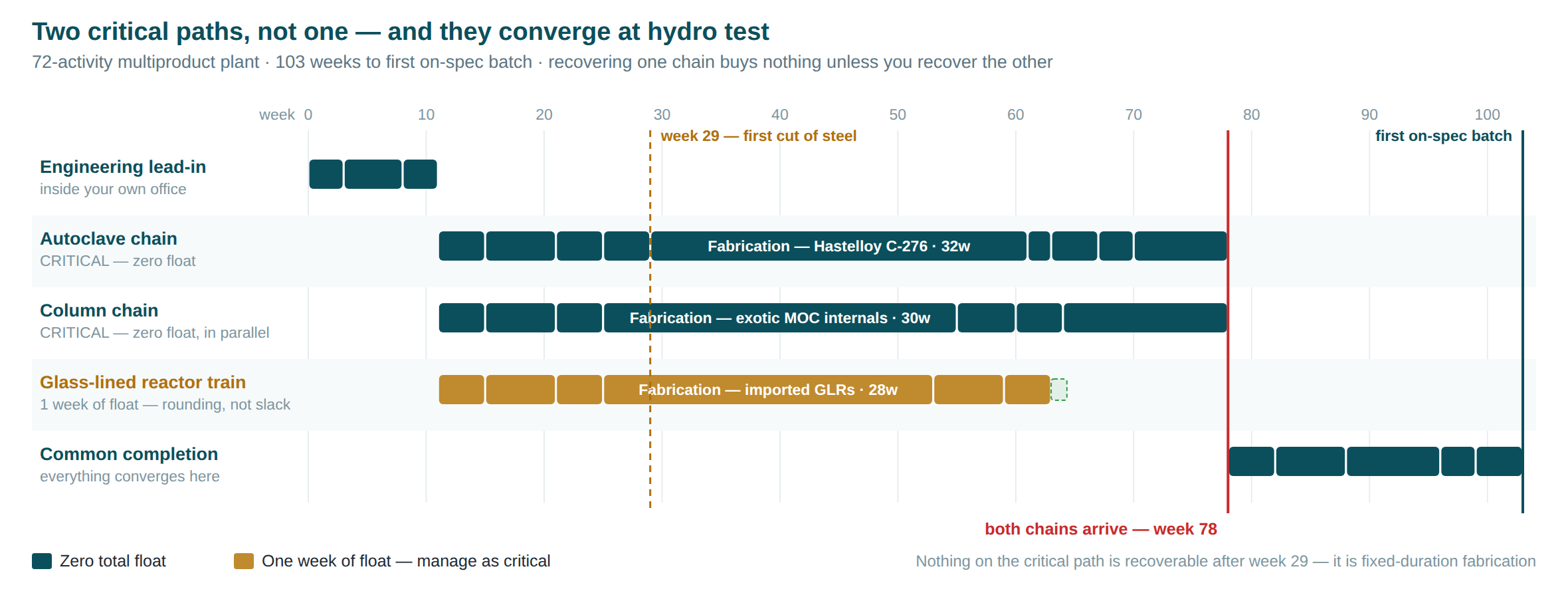

Schedule diagram of the 72-activity multiproduct plant network showing the Hastelloy C-276 autoclave chain and the exotic-MOC column chain both running at zero float and arriving at hydro test in week 78, with the glass-lined reactor train one week behind.
Two critical paths, running in parallel. Both chains leave the same process datasheet (E070) in week 11 and both arrive at hydro test in week 78 with zero float. The glass-lined reactor train sits one week behind them — on a 103-week job that is rounding, not slack. Nothing on either chain is recoverable after week 29, because from there it is fixed-duration fabrication.
Interactive Critical Path Simulator Move any duration and the full forward pass, backward pass and float calculation re-runs across all 72 activities. Nothing here is pre-computed.

Tweak the inputs

What the network now says

First on-spec batch—
Slip vs baseline—
Path / gateFloatState
Baseline: 103 weeks, two parallel critical paths (autoclave and column) converging at hydro test in week 78. Durations in working weeks on a 6-day calendar.
A multiproduct chemical process plant photographed at dawn, showing reaction and distillation trains, structures and interconnecting pipework.
The class of plant this network describes: multiple reaction and separation trains, shared utilities and effluent, and three product campaigns planned in the first year. The schedule question is not how to build it, but which single chain decides when it makes its first on-spec batch.

What the calculation returns

Seven findings, none of which would be visible on a Gantt chart.

#FindingWhy it matters
1There are two critical paths, not oneThe autoclave chain (E070→P010→P020→P030→P040→P050→P060→P070→C070→C100) and the column chain (E070→P130→P140→P150→P160→P170→C090→C110) both arrive at hydro test in week 78. Both carry zero float. Recovering one buys nothing unless you recover the other.
2The first 29 weeks contain no physical workFrom design basis freeze to the IBR Form III-C stamp, the critical path is entirely drawings, enquiries, comparison statements, internal approvals and a regulator. Every week lost here is lost permanently, because everything downstream is fixed-duration fabrication or fixed-duration statutory processing.
3The glass-lined reactor train has one week of floatOne week on a 103-week job is not float, it is rounding. The GLR train is functionally critical and must be managed as a third critical path. The distinction between “critical” and “one week of float” exists only in the software.
4The Consent to Operate has one week of floatS070 finishes in week 98 against a need date of 99. A statutory approval you do not control, one week from driving the end date. This is the single most fragile item in the network and it appears nowhere on a construction dashboard.
5Civil has four to six weeks of float, not twentyPiling and foundations look independent but wait on E140 (load data), which waits on vendor GA drawings. The civil path is not long — it is late-starting. Its float is an artefact of when it is allowed to begin, not of how much slack it has.
6Site enabling, which starts first, has 28 weeks of floatThe activity everyone begins on day one is among the least critical in the network. Early visible progress and schedule health are unrelated.
7HAZOP carries eleven weeks of float — and that is a warningThe float exists only because long-lead datasheets were fast-tracked off IFR P&IDs. The float is real, but so is the exposure: any HAZOP outcome that changes the autoclave datasheet costs the eleven weeks plus a re-approval cycle.

The paths that are not critical, and their real exposure

Path or activityTotal floatAssessment
Autoclave chain0 wksCritical. Fixed-duration fabrication — nothing recoverable after week 29.
Column chain0 wksCritical, in parallel. Same profile.
Glass-lined reactor train1 wkFunctionally critical. Manage identically.
Consent to Operate (S070)1 wkFunctionally critical and outside your control. Highest fragility in the network.
Piling and foundations4 wksInput-constrained, not duration-constrained. Protect the load-data handover, not the crew.
Technological structure fabrication10 wksComfortable, provided E140 holds.
QC method validation (X020)13 wksComfortable on paper. Frequently forgotten entirely, at which point it becomes an eight-week critical activity discovered in week 99.
DCS package (P180–P210)23 wksComfortable, but the IO list freeze that starts it is not.
HT power connection (S050)25 wksComfortable only because it was applied for in week 18. Apply in week 45 and it is critical.
Piping and E&I bulks28–29 wksGenuine float. Candidate for cash-flow deferral if working capital is tight.
CTE amendment (S010)68 wksEnormous float — and zero resilience to a product-slate change after week 71.
Factory building plan approval (S020)89 wksEffectively unconstrained. See the audit note below — this one is unconstrained for a structural reason, not a scheduling one.
The rule the last four rows are teaching

For any activity whose duration is set by a third party, schedule to the late finish but start at the early start. A statutory activity with 68 weeks of float that you begin 68 weeks late is a critical path activity with a regulator on the other end of it. The float protected nothing.

5. Build the Gantt from your own lead times

Every duration in the network above is an assumption — ours. Yours will be different: a different TBE cycle, a different fabrication slot, a different state pollution control board. So rather than ask you to accept the numbers, the tool below hands you all seventy-two of them as editable fields.

Type a duration and the forward pass, backward pass and float calculation re-run across the whole network, and the bar chart underneath is drawn from that result — bar positions, critical path colouring and float tails included. It is not a stored picture with numbers written on it. If your approval loops really do take ten weeks, put ten weeks in and read your own end date off the chart.

Assumption-Driven Gantt Builder Enter your own lead times for any of the 72 activities. The schedule below is computed from what you type, then drawn.
First on-spec batch—
Slip vs baseline—
Zero-float activities—
Assumptions changed—
Lead-time assumptions — edit any of the 72 durations (weeks)

Computed schedule

Hover or tap any bar for its early start, early finish, late finish and total float. Codes in the labels match the activity register above.

Bars run from early start to early finish. The pale tail on a bar is total float — how far that activity can slide before first on-spec batch moves. Dark red bars have none: they are the critical path, computed from your numbers.

6. The 100-day delay stress test

This is DCMA check 12, and it is the fastest way to find out whether a schedule is a network or a picture. Insert a large delay on an activity you believe is critical. If the end date does not move by the same amount, the logic is broken — an open end, a dangling activity, or a hard constraint absorbing the delay. Two minutes, and it catches errors that otherwise surface in month eighteen.

A hundred working days on the 6-day calendar used here is 17 weeks. The tool below applies exactly that to whichever activity you select and re-solves the whole network.

The 100-Day Delay Stress Test Pick an activity, insert the delay, and see whether the project end date moves — or whether float and broken logic absorb it silently.

Select the activity to delay

Or try the classic comparison

Result

New completion—baseline 103
End date moved—
Nothing tested yetChoose an activity and insert the delay.

The arithmetic, step by step

Insert a delay above and every line of the calculation appears here.
A delay of 17 weeks that moves the end date by 17 weeks confirms the activity is on the critical path and that the logic downstream of it is sound. Anything less means float absorbed part of it — or the network has a hole.
Run the test on S020 and watch it fail — deliberately

Delay Factory building plan approval by a hundred days, by a year, by a decade: the end date never moves. That is not resilience, it is an open end. S020 has a predecessor but no successor, so the network has nothing to compare it against and hands it 89 weeks of float by default. This is DCMA check 1 and check 6 firing at the same time, and it is the most common single defect in real schedules.

The fix is not to delete the activity. It is to ask the question the network is refusing to ask: what cannot happen until the factory building plan is approved? Occupancy certificate, most likely, and therefore CTO. Draw that link and S020’s float drops from 89 weeks to something that means something. We left the open end in this published network on purpose, so the audit checklist below has something real to catch.

7. The critical path migrates — and each move catches somebody

The largest single error in project controls is calculating the critical path once, printing it, and laminating it. On a plant of this type the path moves in a recognisable pattern.

Timeline showing the critical path of a chemical plant project migrating across four phases: engineering approval loops in weeks 0 to 30, vendor fabrication in weeks 25 to 65, dense pipe-rack construction in weeks 60 to 88, and commissioning with statutory clearance in weeks 82 to 103.
The path does not stay where you found it. Each phase hands the constraint to a different organisation — your own office, then a vendor’s shop floor, then the congestion in your own pipe rack, then a regulator. Each handover catches an organisation that stopped recalculating.
PhasePath runs throughWhat to actually do
Wk 0–30
Engineering & long-lead PO
Drawings, datasheets, enquiries, TBE, PO, vendor GA and IBR approvalThis is the only phase where the critical path is entirely inside your own office — and the phase where organisations are most relaxed about it. A P&ID review cycle that slips two weeks because a reviewer was travelling has cost the project two weeks of end date, and nobody will connect those events fourteen months later. Compress the approval loops, not the engineering.
Wk 25–65
Fabrication
Vendor shop floors — autoclave, column, GLR trainYou can do almost nothing about the critical item; it is being welded. Two things matter. Attend every stage inspection — material clearance, weld stage, hydro, final — because each unattended stage is a potential three-week rework. And stop watching the critical path; watch the near-critical ones. Your next critical path is being manufactured in a smaller vendor’s shop with a sub-supplier problem nobody has mentioned.
Wk 60–88
Construction
Equipment erection, then piping and E&I in the densest moduleThe transition is abrupt and usually noticed a month late. Watch for it when equipment erection reaches roughly 60%: the constraint stops being “has the equipment arrived” and becomes “can four trades work in the same eight metres of pipe rack.” CPM assumes infinite resources; there are not infinite welders qualified for Hastelloy. Resource-level the last three months.
Wk 82–103
Commissioning
Utilities, statutory clearance, analytical readinessThe path moves to places most schedules never contained. Utilities must be live before anything else commissions, so it runs through chilled brine and thermic fluid, not through the reactor. CTO and PESO become the last gates. And QC method validation for Product 1 is a real eight-week activity on nobody’s contract that has stopped more first batches than any equipment failure.
A plant operator monitoring a process plant from the control room, with the DCS graphics on multiple screens.
By week 88 the critical path has left the construction site entirely. It runs through loop checks, DCS integration, utilities that must be live before anything else can commission — and through an analytical method that nobody put on a contract.

The multiproduct-specific problem

On a single-product plant there is one critical path to one finish. On a multiproduct plant there is a critical path to first batch, and then a separate, shorter critical path for every subsequent campaign — changeover and cleaning validation, product-specific gaskets and seal elastomers, product-specific effluent characterisation, and sometimes a product-specific consent condition.

Two rules follow, and both are commercial decisions dressed as scheduling ones.

  • Sequence the technically simplest product first, not the most profitable one. The first campaign is a commissioning event, not a revenue event. Running the highest-margin, tightest-spec product first means debugging the plant and the process simultaneously, and you will not be able to tell which one is failing.
  • Treat each campaign as its own mini-project with its own network. Otherwise campaign 2 arrives with nobody having ordered the Kalrez seals, and it is discovered at changeover.

8. Float erosion — the chart that warns you first

Percentage complete is an opinion. Remaining duration is a claim that can be tested. The difference between the two is visible in the chart below, which plots a real twenty-four-month scenario on the same 72-activity network: a glass-lined reactor vendor who starts slipping quietly in month three and never recovers.

Both panels below are computed from the same network, re-solved at every monthly data date. Watch the month the two panels disagree.

Float Erosion Trend Tracker One scenario, two reporting systems. Hover or tap any month to read both panels at that data date.
Float first hits zero—
End date first moves—
Final slip—
Warning gained—

Panel A — Total float on the four monitored paths (weeks)

Panel B — Duration-weighted progress reported to the board (%)

Scenario: GLR vendor drawing approval creeps two weeks from month 3; GLR fabrication then slips one week per month from month 5; piling, HT power and CTO each drift later. Autoclave and column vendors perform exactly to plan throughout.
Read what just happened

The autoclave and column chains started this project critical and stayed on programme the whole way — and by month 13 both show nine weeks of float. They did not improve. They stopped being critical because something else got worse. A project manager watching only “the critical path” would have reported improving health for eight consecutive months while the completion date moved twelve weeks.

Meanwhile the progress line in Panel B never once bends. It cannot: it is measuring work done against a schedule that is itself moving. A percentage-complete curve cannot show a slip, because the denominator slips with the numerator.

9. Keeping the critical path honest

FrequencyActivityDetail
WeeklyProgress update against the networkActual start, actual finish, remaining duration. Not percentage complete — remaining duration. “80% complete” is an opinion; “eleven days remaining” is a claim that can be tested.
MonthlyFull recalculation with re-logicAnswer four questions in writing: What is the critical path this month? What are the top three near-critical paths and their float? Which paths lost float since last month, and why? Has the critical path changed — and did anyone notice at the time?
MonthlyFloat erosion chartPlot total float of the top five paths week by week. A path steadily losing float is your next critical path, and the chart says so before the arithmetic does. This single graph is worth more than most monthly review decks.
At each rebaselineCritical path testInsert a 100-day delay on an activity you believe is critical. If the end date does not move by 100 days, the logic is broken.
At each rebaselineNetwork structure auditRun the fourteen checks below.
Every change requestTest before approval, not afterA design change adding two weeks to a non-critical path is free. The same change on the critical path costs two weeks of end date and a quantifiable amount of interest during construction. The approving authority is entitled to know which one it is at the time of approval.

10. The 14-point network audit

Adapted from the DCMA 14-point check for chemical project networks. Run it at every rebaseline, and run it on any contractor schedule before you accept it.

#CheckThresholdWhat a failure means
1Logic — open endsEvery activity has a predecessor and a successor, except project start and finishDangling activities absorb delay silently; the critical path test will fail
2Relationship typesAt least 90% finish-to-startHeavy SS/FF use usually means the decomposition is wrong
3Leads (negative lag)ZeroA lead is almost always a modelling cheat for overlap that should be an activity
4LagsUnder 5% of links; none longer than the activity it connectsA long unexplained lag is a duration someone did not want to name
5Hard constraintsUnder 5% of activitiesThe network has stopped calculating and started obeying
6High floatUnder 5% of activities above 44 working daysUsually missing successor logic, not genuine slack
7Negative floatZeroThe schedule is already telling you the date is unachievable
8High durationUnder 5% above 44 working daysActivities too coarse to measure or to place on a path
9Invalid datesNo actuals in the future, no forecasts in the pastProgress data is not being maintained
10ResourcesLoaded on all activities with cost or manpowerWithout this you cannot detect the week 60–88 congestion shift
11Missed tasksUnder 5% finishing late against baselineBaseline is drifting from reality
12Critical path test100-day delay moves the end date by 100 daysBroken logic
13CPLIAt or above 0.95Critical path is losing efficiency
14BEIAt or above 0.95Activities are completing slower than baselined

11. How the critical path gets hidden

What to look for when a schedule looks too comfortable.

PatternHow it looksWhat it is actually doing
Lags as concealed durationA 30-day FS lag with no stated reasonHiding a duration nobody wanted to own
Constraint-driven schedule“Start no earlier than” on forty activitiesThe network is being told what to do instead of calculating
Level-of-effort on the path“Project management” as a 500-day barSits on the critical path and tells you nothing
Contractor schedule with no client interfacesClean, all-FS, ends exactly on the contract dateFree-issue items, client-supplied catalyst, licensor DCS logic and owner approvals are absent — so the contractor’s critical path is fiction and yours is unknown
Missing approval cyclesPO placed the week after TBEFour to ten weeks of undeclared duration on a typical Indian project
No calendar appliedA schedule on 365 working daysMonsoon restrictions on heavy lifts, festival shutdowns and tie-in windows — off by roughly 15% before it starts
Baseline never re-runThe same critical path in month 4 and month 18Nobody has recalculated; the real path moved two phases ago

Appendix — building this in Excel

Three sheets. The design below reproduces the 72-activity calculation exactly and stays maintainable through the life of the project. You do not need Primavera to do this properly; you need correct logic and the discipline to re-run it.

Sheet 1: ACTIVITIES

One row per activity. Columns A–E are entered; F–K are calculated; L onward are for progress tracking.

ColHeaderTypeContent / formula (row 2)
AIDEntryUnique activity ID, e.g. P050. Keep the workstream prefix — it makes filtering trivial
BWorkstreamEntryEngineering / Procurement / Construction / Statutory / Commissioning
CActivityEntryDescription. One owner, one deliverable
DDurationEntryWorking weeks (or days — stay consistent)
EPredecessorsEntryComma-separated IDs. Reference only; the LINKS sheet drives the maths
FESCalc=MAXIFS(LINKS!$E:$E, LINKS!$B:$B, $A2)
GEFCalc=F2+D2
HLSCalc=I2-D2
ILFCalc=IF(COUNTIF(LINKS!$A:$A,$A2)=0, $P$1, MINIFS(LINKS!$F:$F, LINKS!$A:$A, $A2))
JTotal floatCalc=H2-F2
KCriticalCalc=IF(J2=0,"YES",IF(J2<=ROUND($P$1*0.05,0),"NEAR",""))
LOwnerEntryNamed individual, not a department
MBaseline finishEntryFrozen copy of EF at baseline. Paste as values
NActual startEntryBlank until started
ORemaining durationEntryUpdated weekly. This is what you ask for, not % complete
PFloat last periodEntryPaste of column J from last month, as values
QFloat deltaCalc=J2-P2 — negative means the path is eroding

Put the project duration in a single named cell (shown above as $P$1) with =MAX(G:G). Activities with no successor take their LF from it.

Sheet 2: LINKS

This is the sheet that makes the formulas work. One row per relationship — an activity with three predecessors gets three rows. Normalising the logic this way avoids all the fragile text-splitting that comma-separated predecessor lists otherwise force on you.

ColHeaderTypeContent / formula (row 2)
APredecessorEntryActivity ID that must happen first
BSuccessorEntryActivity ID that follows
CTypeEntryFS, SS, FF. Keep it at FS unless you can justify otherwise
DLagEntryUsually 0. Anything non-zero needs a written reason in column G
EPred EF + lagCalc=INDEX(ACTIVITIES!$G:$G, MATCH($A2, ACTIVITIES!$A:$A, 0)) + $D2
FSucc LS − lagCalc=INDEX(ACTIVITIES!$H:$H, MATCH($B2, ACTIVITIES!$A:$A, 0)) - $D2
GReason for lagEntryBlank if lag = 0. If not blank, it should read like an activity
Enable iterative calculation

ES depends on predecessor EF, which depends on that activity’s ES, and so on. The dependency graph is acyclic so it resolves correctly, but Excel’s reference tracker flags it as circular. Go to File → Options → Formulas → Enable iterative calculation, maximum iterations 100, maximum change 0.001. The forward and backward passes then converge in a fraction of a second.

Comparison photograph of on-spec white crystalline product against off-spec discoloured material, illustrating the difference between mechanical completion and a saleable first batch.
This is the finish line, and it is the only one a promoter recognises. Not mechanical completion, not RFSU, not first product — first product that meets specification. On a multiproduct plant the gap between the first and the last of those is routinely four to six months.

The one-paragraph version

The critical path is not the expensive equipment, and it is not the thing your monthly review has photographs of. It is the longest chain of dependent activities in a network you actually built, and on a chemical plant it spends its first thirty weeks inside your own office and its last twenty weeks inside a regulator’s. Calculate it from logic, recalculate it every month, track remaining duration rather than percentage complete, and watch the float on the paths that are not critical — because one of them is about to be.

Have questions about your plant schedule or project bottlenecks?

We build and audit execution networks for chemical and specialty chemical projects — critical path determination from first principles, DCMA-style schedule audits, float erosion tracking, and independent review of contractor programmes before you accept them. If you would like your own network looked at, or a second opinion on a schedule that suddenly looks comfortable, send the question straight through to our engineering team.

It reaches Saswat Satpathy at Orissa Engineering directly. Prefer email? saswatsatpathy080390@gmail.com

About the calculation. Every figure in this article — the 75-week block, the 103-week network, all ES / EF / LS / LF / total float values, and every result the three tools produce — is computed by a forward-pass / backward-pass CPM solver running on the 72-activity register described above. Nothing is hardcoded and nothing is asserted. The network deliberately retains one open end (S020) so the audit section has a live defect to demonstrate. Published by Orissa Engineering, orissaengineering.com.

Ask a critical path question

Your question goes straight to Saswat Satpathy at Orissa Engineering. The more specific you are about the project stage and which date is under pressure, the more useful the answer will be.
